How Long Does a Kitchen Renovation Take in Boston

In Greater Boston, a cosmetic kitchen refresh usually takes 6 to 12 weeks, a mid-range renovation often runs 3 to 5 months, and a full gut or structural remodel can stretch to 6 months or more. The active build is often only 6 to 12 weeks, while the rest of the calendar goes to design, permits, and procurement.

In Cambridge and Newton, that's the part homeowners usually underestimate. They hear a contractor say “two months,” then realize that the clocks for cabinet ordering, permit review, inspections, and countertop templating start long before demo day.

Table of Contents

How Long Does a Kitchen Renovation Take in Greater Boston

A homeowner in Newton MA can have a very different experience from a homeowner doing a same-looking kitchen in Cambridge MA. The trade work may be similar, but the total kitchen renovation Greater Boston timeline is usually set long before demo starts, by layout decisions, finish selections, permit review, and material ordering.

That is why people hear conflicting answers. A national remodeling guide from Pro House Maintenance reports an average planning and design phase of about 9.5 months and an average construction phase of about 5.8 months once work begins, while the same source says simple cosmetic refreshes can finish in roughly 6 to 12 weeks and full structural overhauls may need six months or more of active construction.

That does not mean every kitchen takes nearly a year. It means the calendar is front-loaded. We spend time locking down the plan, confirming what gets ordered, and clearing permit issues so the build does not stall once crews are on site.

Practical rule: if a project needs custom cabinetry, plumbing changes, or layout changes, the schedule usually stretches because the job is waiting on decisions and ordered materials as much as on labor.

For homeowners asking how long does a kitchen renovation take, the better question is how much of that time belongs to preconstruction. In Massachusetts, a licensed general contractor has to sequence design, procurement, and permit work before the house can move into active construction, and that is what pushes the total calendar to about 3 to 9 months even when the hard work on site may only last 6 to 12 weeks.

Kitchen Renovation Timelines by Project Scope in Massachusetts

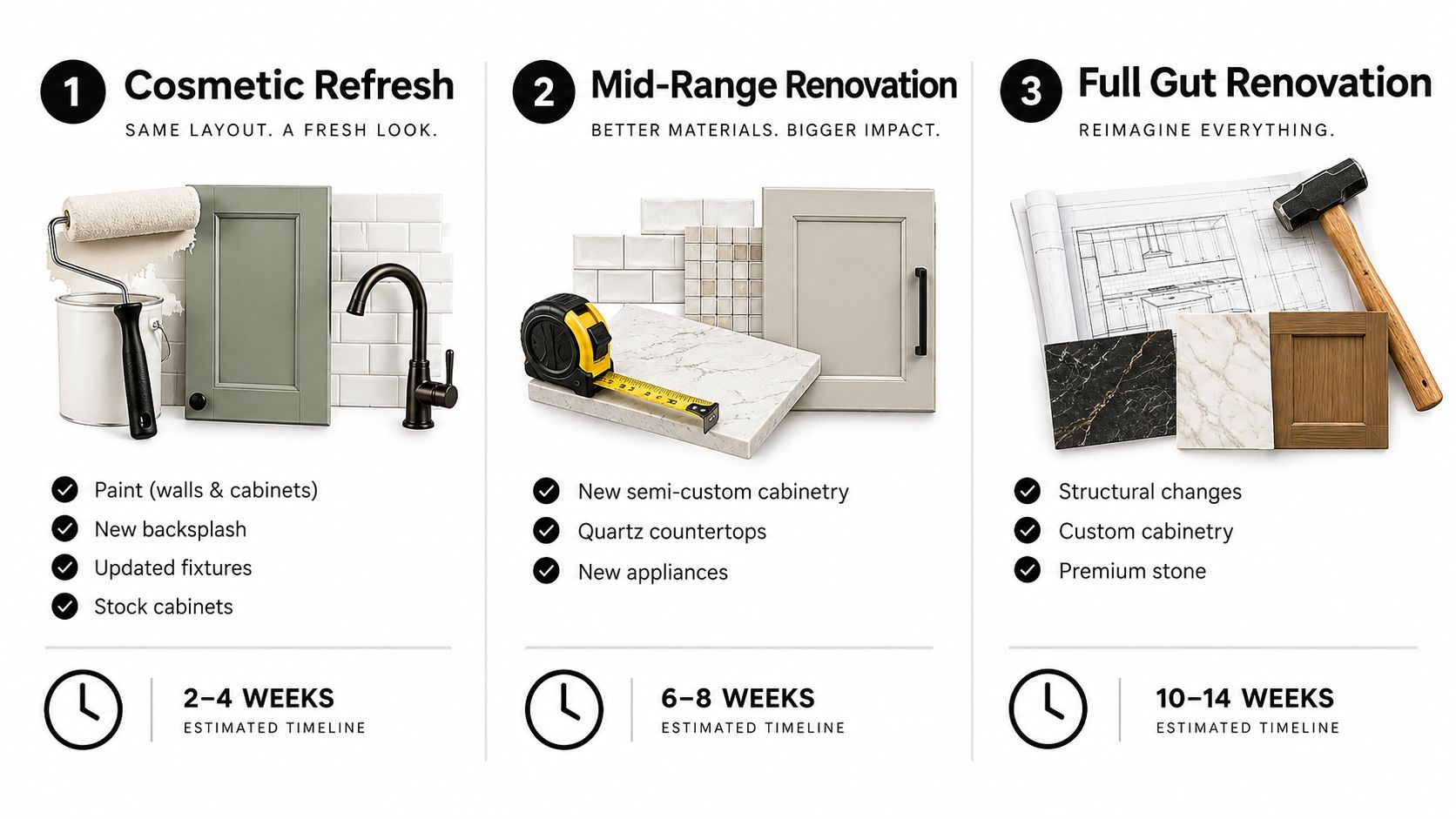

A graphic showing three levels of kitchen renovation with associated project timelines and typical work inclusions.

A kitchen job in Belmont, Somerville, Medford, or Wellesley usually starts looking “slow” long before demo day. Cabinet lead times, appliance availability, design approvals, and permit review all sit on the front end of the schedule, and that is why the total calendar can stretch well beyond the time crews are swinging hammers.

Cosmetic refresh in Belmont or Somerville

A cosmetic refresh moves fastest because we keep the footprint and the trades light. Paint, backsplash, fixtures, hardware, and a sink swap can often fit inside the active 6 to 12 week build window noted in industry guidance, and smaller jobs may finish sooner when materials are on hand HGTV.

Mid-range renovation in Medford or Wellesley

A mid-range job adds new cabinets, counters, appliances, and some plumbing or electrical work. That changes the rhythm of the project because the schedule now depends on ordering, delivery timing, and inspection slots, not just labor. For many kitchen renovation Wellesley and kitchen remodeling Newton projects, the total calendar often lands in the 3 to 5 month range once design, procurement, and approvals are folded in Kitchen Budget Planner.

Full gut or structural remodel in Lexington or Brookline

A full gut brings wall changes, new layouts, major electrical and plumbing work, and custom finishes. The work itself is only part of the timeline. We spend more time coordinating permits, rough-in sequencing, and material arrivals so the site does not sit idle between trades. In that kind of job, the schedule can extend to six months or more of active construction, depending on scope and review cycles.

Kitchen Renovation Timeline by Scope in Greater Boston Active Construction Total Calendar Time
Cosmetic refresh about 6 to 12 weeks often shorter overall when selections are simple
Mid-range renovation about 6 to 12 weeks often 3 to 5 months
Full gut or structural remodel about 6 to 12 weeks of building activity, sometimes longer 6 months or more

After the dust settles, the cleanup still needs a plan. We usually point homeowners to Professional Window Cleaning's cleanup guide because floors, windows, trim, and cabinet faces all pick up fine dust that needs a proper final pass.

Phase by Phase Kitchen Remodel Schedule From Design to Final Inspection

The most useful way to think about a remodel is as a chain of dependencies. Each step precedes the next one, and when one selection slips, the rest of the schedule shifts with it.

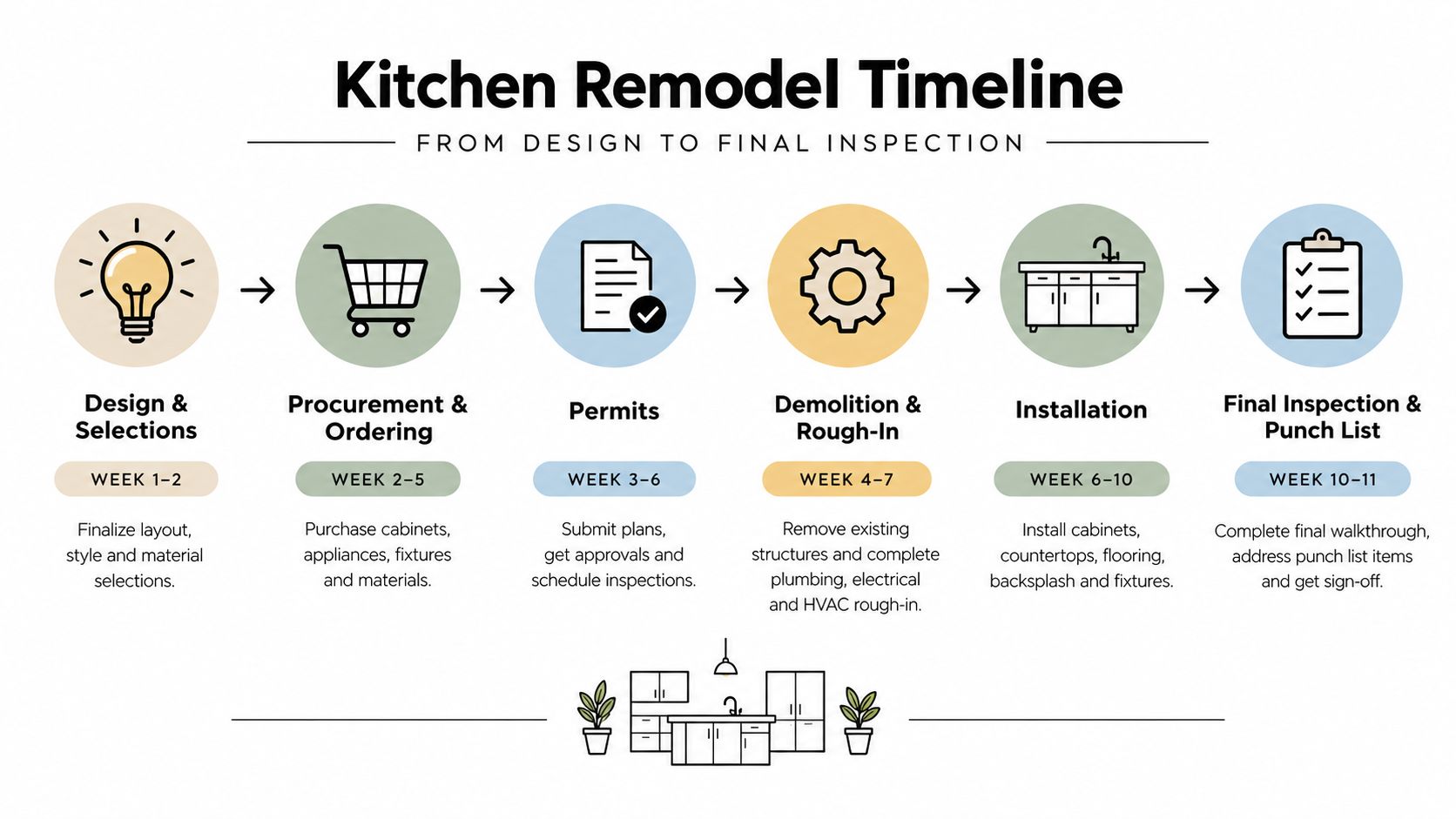

A step-by-step infographic showing the timeline for a kitchen remodel from initial design to final inspection.

Design, selections, and ordering

Schedule begins. We lock in cabinet style, appliance sizes, lighting, tile, and any layout changes before demolition starts, because late choices create rework. In many cases, this stage takes the longest portion of the overall calendar.

Permits and approvals

If the job changes structure, plumbing, electrical, or layout, permits need to move in parallel with design. In Massachusetts, that's not optional for most substantive remodels, and local review can be slower when the footprint changes or the kitchen layout moves.

Demolition, rough-ins, and inspections

Once work starts, the crew removes the old kitchen, then performs framing, electrical, plumbing, and any ventilation rough-ins. Inspections create pauses by design, because the work has to be checked before it gets covered up. That pause is normal, and it's part of a controlled build, not a delay by itself.

Cabinets, countertops, and finish work

Countertops can't be templated until cabinets are set and level. That one dependency is where many homeowners lose time if the cabinet delivery slips or if final measurements change. After that comes tile, trim, paint, appliance hookups, punch list work, and the final inspection.

The internal sequence matters more than the calendar on the wall. If you want to see how a contractor organizes that sequence, our kitchen renovation process shows the same kind of step-by-step logic we use on active jobs.

Why Material Lead Times and Decisions Drive Your Kitchen Timeline

The biggest hidden driver is procurement. Stock cabinets can move relatively quickly, but semi-custom and custom options stretch the schedule because the job is waiting on factory production, shipping, and delivery windows. One industry source cites cabinet lead times of 2 to 3 weeks for stock cabinets versus 16+ weeks for semi-custom options Clar Construction.

That gap changes everything. If the cabinets aren't on site, templating can't happen, countertops can't be cut, and final install gets pushed back. The same logic applies to specialty stone and imported tile, which are often chosen for appearance but behave like schedule variables once they're ordered.

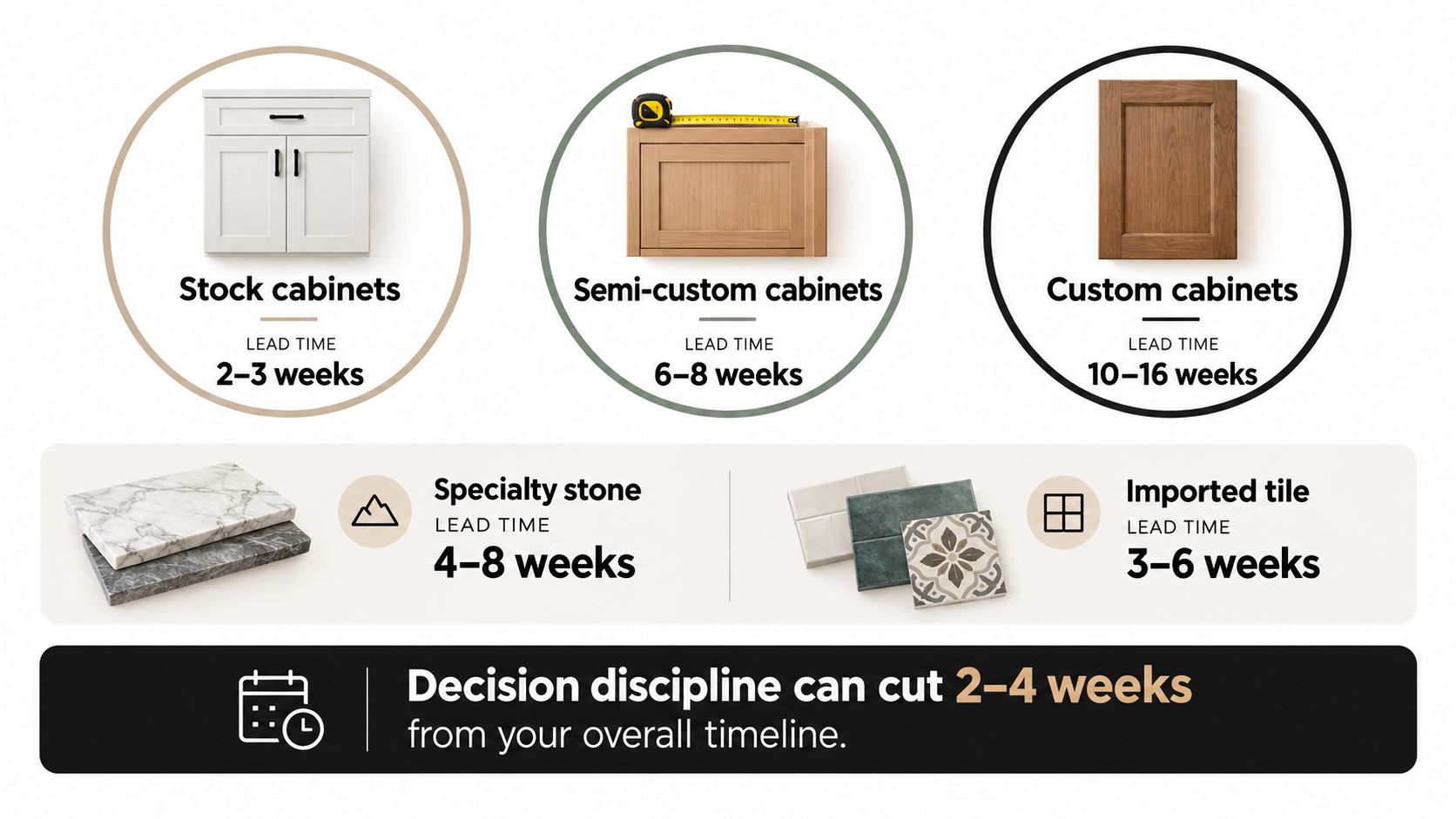

A chart comparing estimated lead times for kitchen cabinets, specialty stone, and imported tile renovation materials.

Late selections don't just delay one trade. They can force a whole chain of rescheduling.

We protect the critical path by pushing decisions early. When the homeowner finalizes cabinet lines, stone selection, tile, and appliance specs up front, the job moves cleaner and avoids stop-and-start labor. That discipline is usually worth more than trying to rush the field crew later.

A recent timeline guide also notes that the full process is commonly 3 to 6 months or longer once design, permits, and material lead times are included, while active construction is usually only 8 to 12 weeks CliqStudios. That's the clearest proof that speed is often a decision problem first and a labor problem second.

Permit Requirements and Inspections for Kitchen Remodels in Massachusetts

Massachusetts changes the calendar in ways national articles often ignore. Under the MA State Building Code, 780 CMR, a building permit is required for construction, reconstruction, alteration, repair, removal, demolition, or changes in use or occupancy, while ordinary repairs are not permit-triggering work CodeRed Consultants.

For kitchen work, that matters because plumbing changes, electrical changes, and structural changes usually push the project into permit territory. Local guidance in Massachusetts also notes that separate electrical and plumbing permits are typically needed in addition to the building permit MCity Builders. In some towns, if fixtures move, a layout plan is required as part of the review packet, which means the permitting office is looking closely at the actual footprint, not just the finishes Hamilton MA.

Permit timing isn't uniform. Some municipalities can approve residential permits in 5 to 10 business days, while others queue them for 3 to 6 weeks during busy periods Angi. That's why a kitchen renovation in Belmont, Medford, or Wellesley can start on different dates even when the design looks similar.

We handle those filings and the inspection schedule so trades aren't guessing. If a homeowner wants support on the front end, our permit expediting services are built for exactly that kind of coordination.

What to Expect From a Kitchen Remodel in Medford MA With Aureli Construction

A Medford kitchen remodel usually starts long before demo day. We begin with design, finish selections, permit drawings if needed, and procurement, because cabinets, counters, fixtures, and appliances set the calendar. The on-site build is often only part of the total job, while the rest of the time goes to approvals and ordering.

For most homeowners, that means the question is not just how long construction takes. It is how long the whole process takes, from first decisions to final inspection. In Greater Boston, a straightforward cosmetic update can move faster, while a custom or structural kitchen renovation in Medford takes longer once cabinetry, stone, plumbing moves, and finish carpentry enter the plan.

A kitchen renovation 10-week timeline schedule sits on a clean marble island in a modern white kitchen.

A full gut in Lexington or Wellesley needs a different calendar. Layout changes, permits, and inspections add steps before the finish work can move quickly. If you're comparing kitchen remodeling options in Lexington or planning a broader Greater Boston kitchen remodel, a design-build approach helps keep selections, drawings, and trades in the right order.

We also plan for the reality of living through the work. Temporary kitchen setup, dust control, daily cleanup, and clear communication matter as much as framing and cabinets when the family stays in the house.

Practical rule: if you're living at home during a remodel, protect the cooking zone, the dust path, and the access route before demo starts.

For homeowners who want a broader house plan beyond one room, our home additions team often coordinates kitchen work with layout changes elsewhere. We also reference revitalizing Medford homes when we talk through projects that fit the house as a whole. If you're ready to talk through your kitchen, contact Aureli Construction for a free estimate at homeadditionma.com.

Kitchen Renovation Timeline FAQs for Greater Boston Homeowners

How far in advance should I book a contractor?
Book us once the scope is clear, before final selections and permit drawings are complete. That lead time lets us coordinate cabinets, appliances, subcontractors, and the local review process. Total calendar time often reaches three to nine months, even though construction may take only six to twelve weeks.

Can I live at home during the remodel?
Usually. We set up a temporary kitchen, isolate the work area, and protect the route between the entrance and the site. A full gut remains disruptive, particularly when plumbing or electrical work requires repeated inspections.

What causes the biggest delays in Massachusetts?
Permit review, inspection availability, and material lead times. Cambridge, Belmont, and Wellesley can follow different review schedules, so the town and product selections affect the start date.

How do change orders affect the schedule and budget?
A revised layout, tile choice, light location, or cabinet order can require new approvals, reordered materials, or trade resequencing.

Aureli Construction handles design, permitting, and construction. Discuss your project at homeadditionma.com.

Leave a Reply

Your email address will not be published. Required fields are marked *

Sign up our newsletter to get update information, news and free insight.

Related Article

Bathroom Remodel Timeline: What to Expect

In Cambridge, we regularly meet homeowners in triple-deckers who think a gut bath renovation will take three weeks because the room is small. Then the
